October 2024

Dramatic début

A new 700 tonne telescopic crane from Prangl was used successfully for the first time to do lifting work at the AustroCel site in Hallein.
Country:Austria
City:Hallein
Date:16.09.2024 – 04.10.2024
Sales:Silvio Auinger
Alexander Albert

The challenge

Exceptional deployment

The Prangl team carried out a special assignment at Hallein: AustroCel, a manufacturer of environmentally-friendly pulp and bio-energy, commissioned the family business with demanding lifting work. The goal of the project was to replace massive heat exchanger packs - each 5 metres long, 3.4 metres wide, 1.6 metres high and weighing about 28 tonnes - which needed to be moved precisely and safely.

Our solution

Precise planning

The special conditions on-site presented the Prangl team with exciting challenges. Tightly confined spaces, high buildings and numerous towers required accurate planning. Several on-site visits and precise measurements resulted in a convincing concept that ensured smooth implementation and compliance with the planned downtime of the plant.

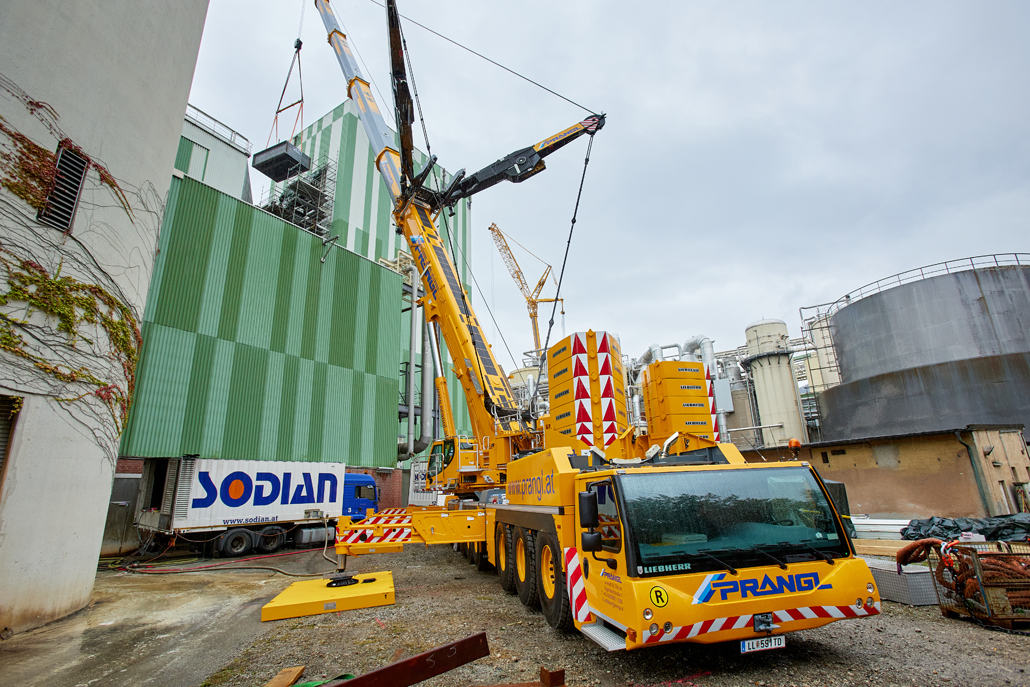

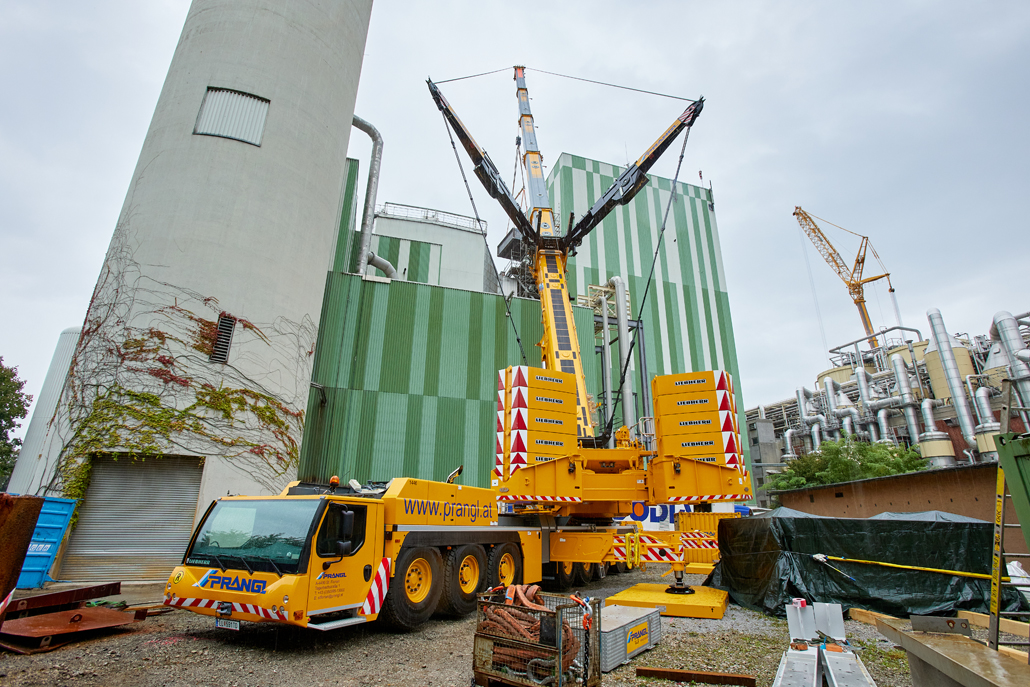

700 tonne telescopic crane

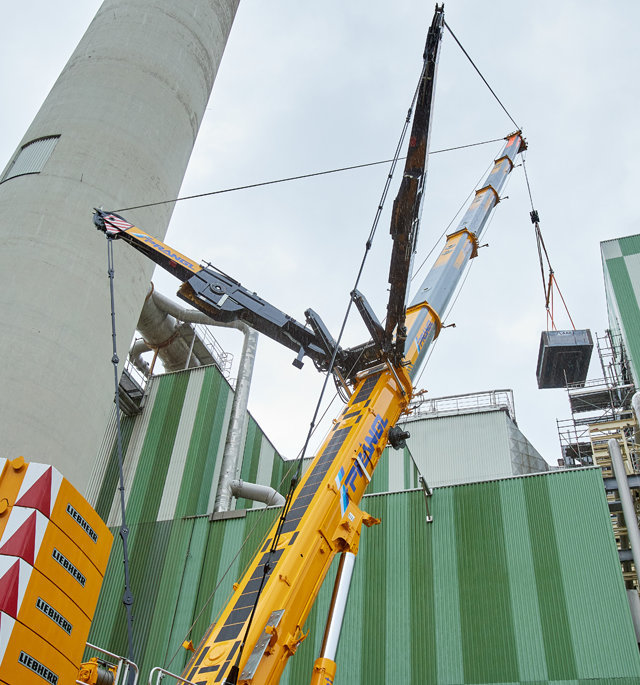

The latest achievement of the Prangl fleet was used here for the first time: a 700 tonne telescopic crane; a mobile heavy-duty crane of the latest generation. This 8-axle crane stands out with its impressive load-bearing capacity values, exceptional power and high flexibility - ideal for the demands of this project. The crane was optimally prepared for the requirements with TY-anchoring, a 69 metre main boom and 120 tonne ballast.

Works steps with millimetre precision

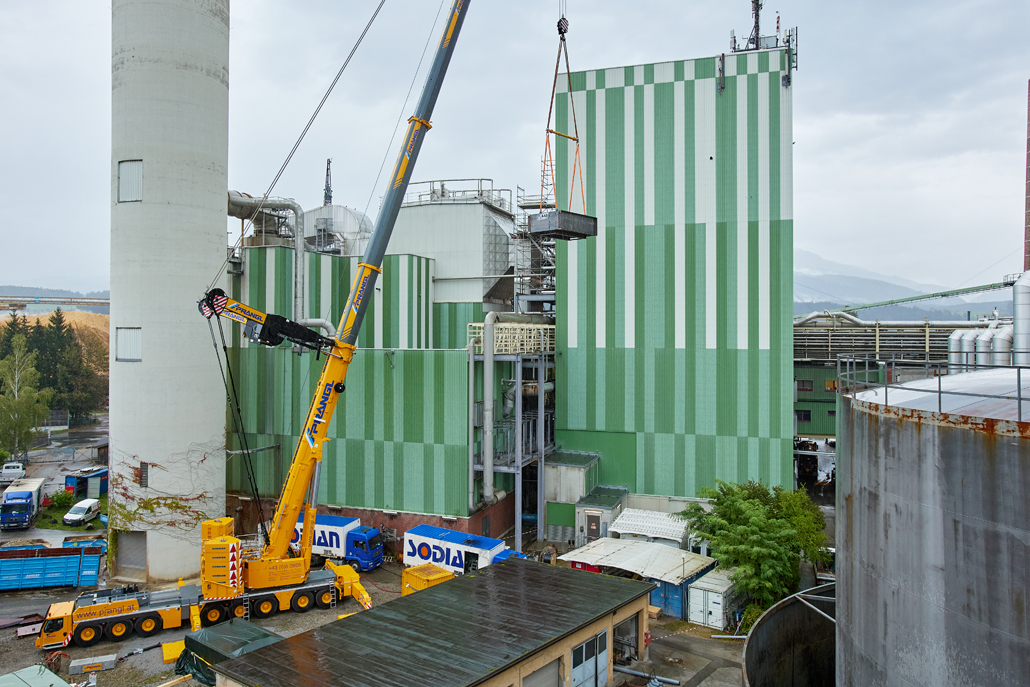

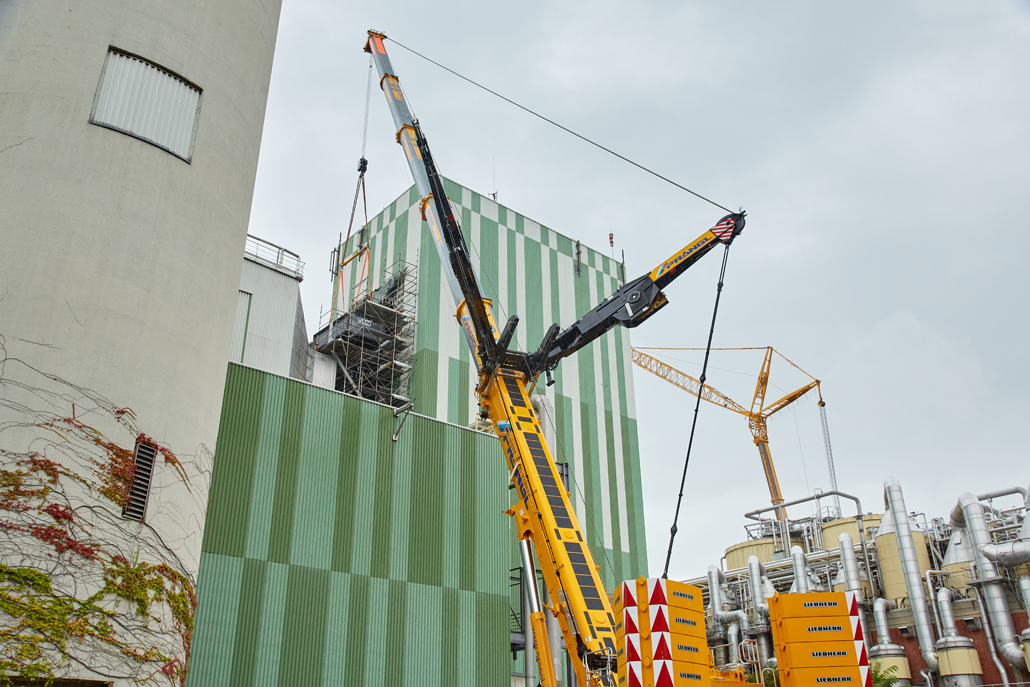

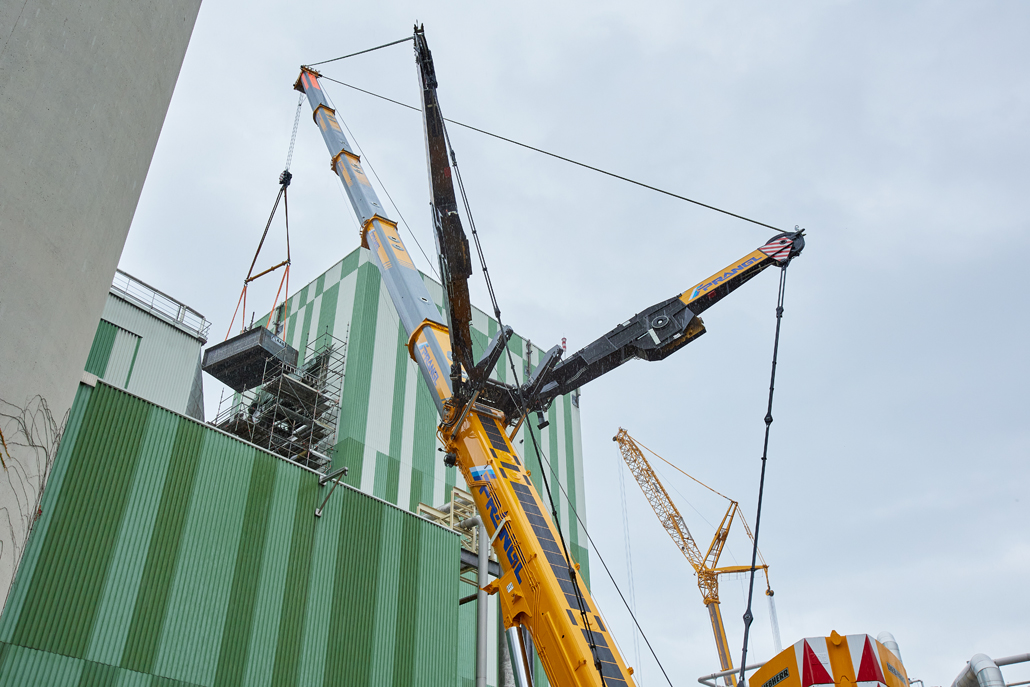

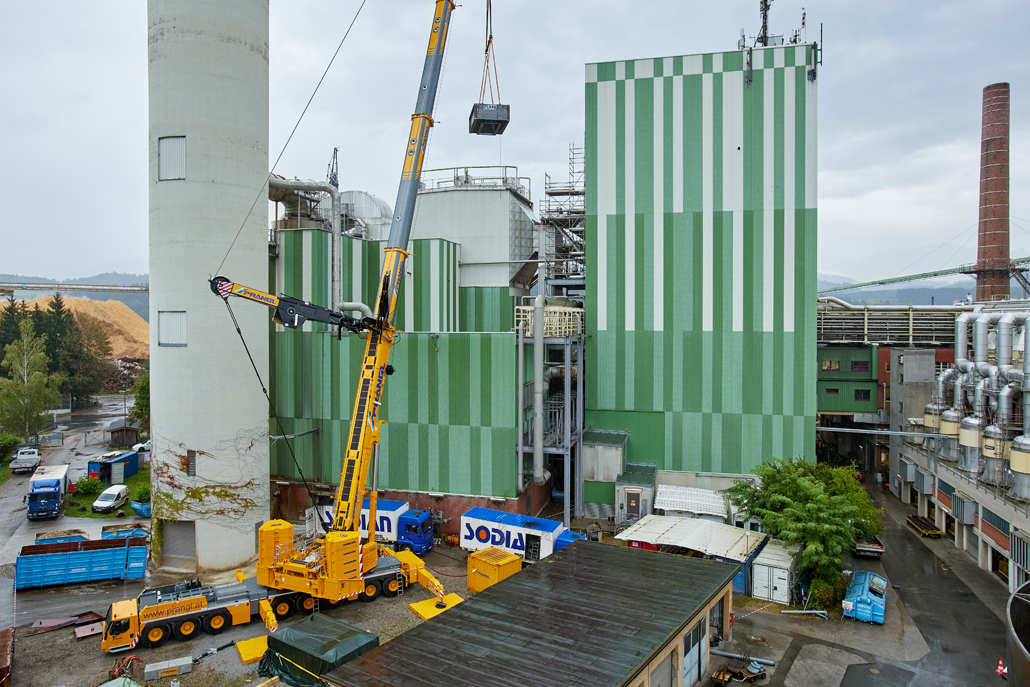

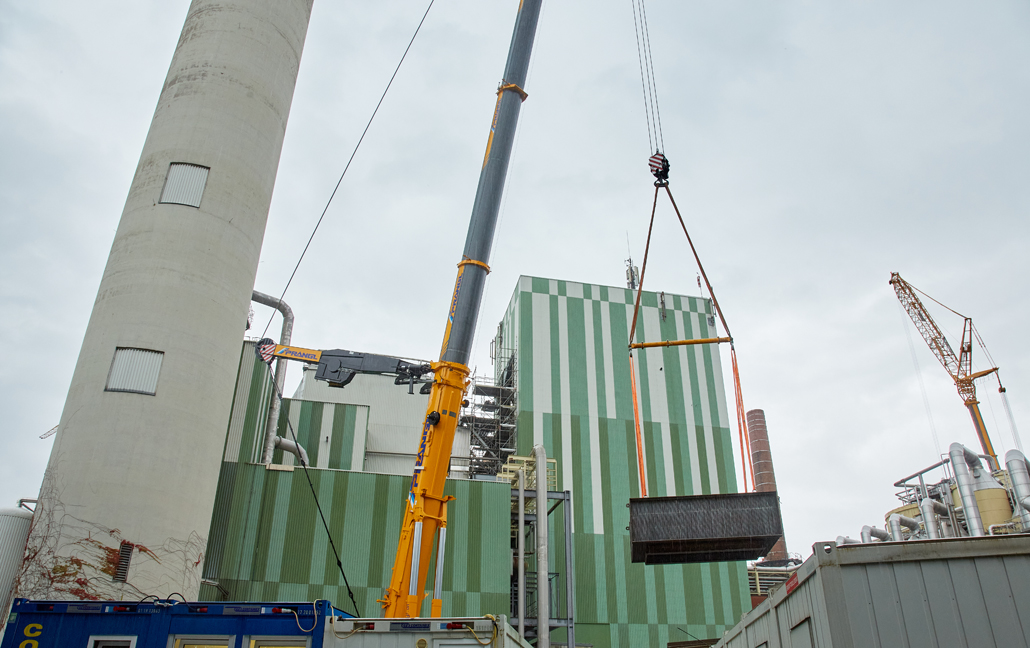

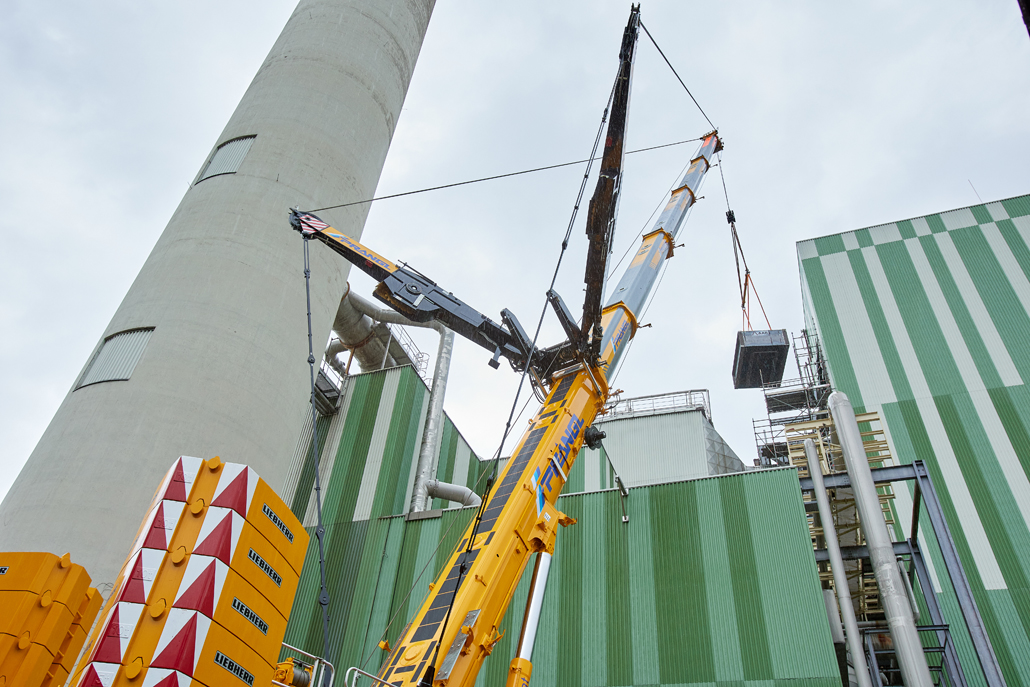

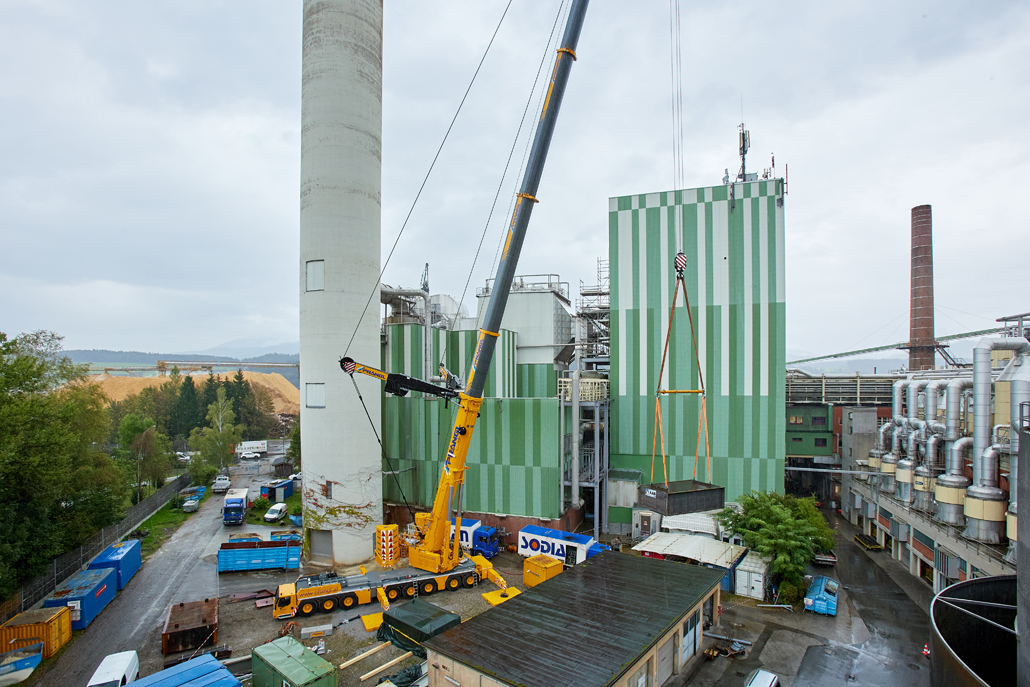

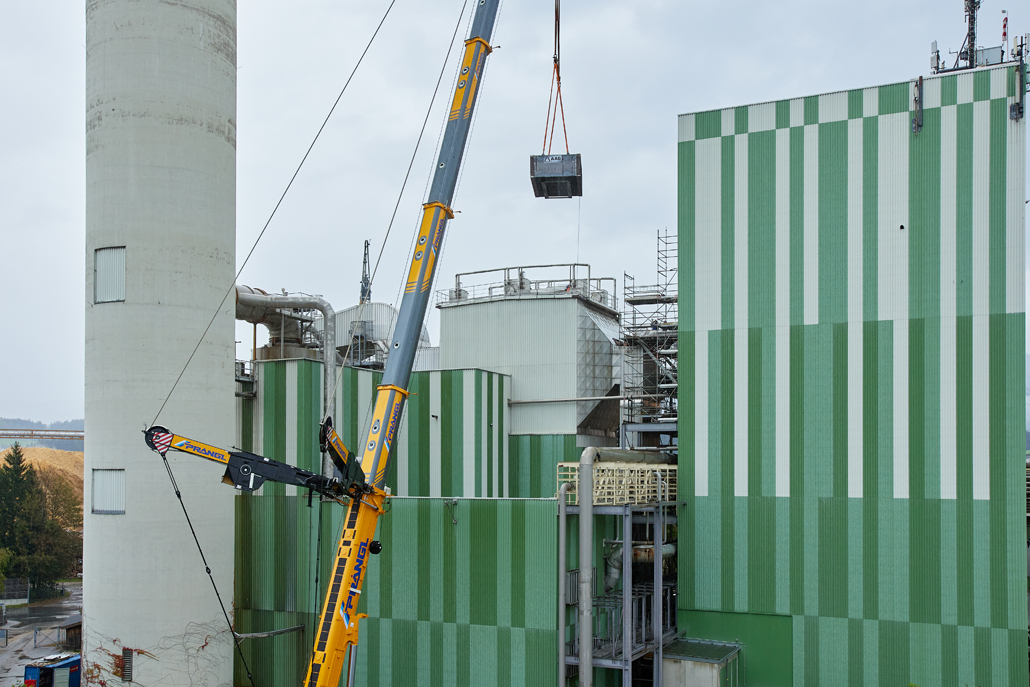

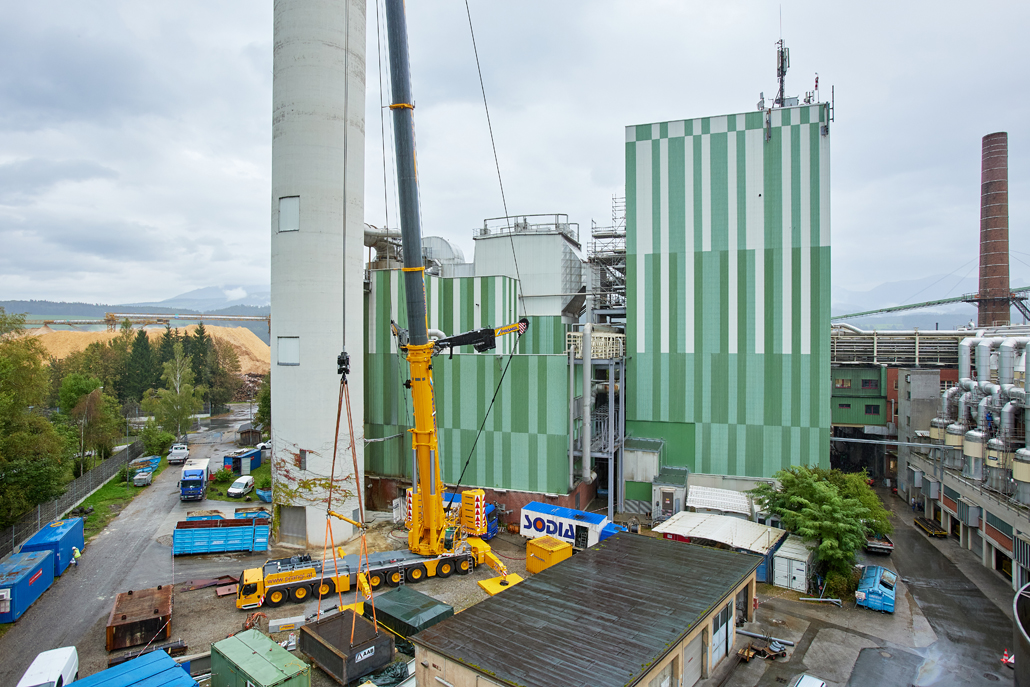

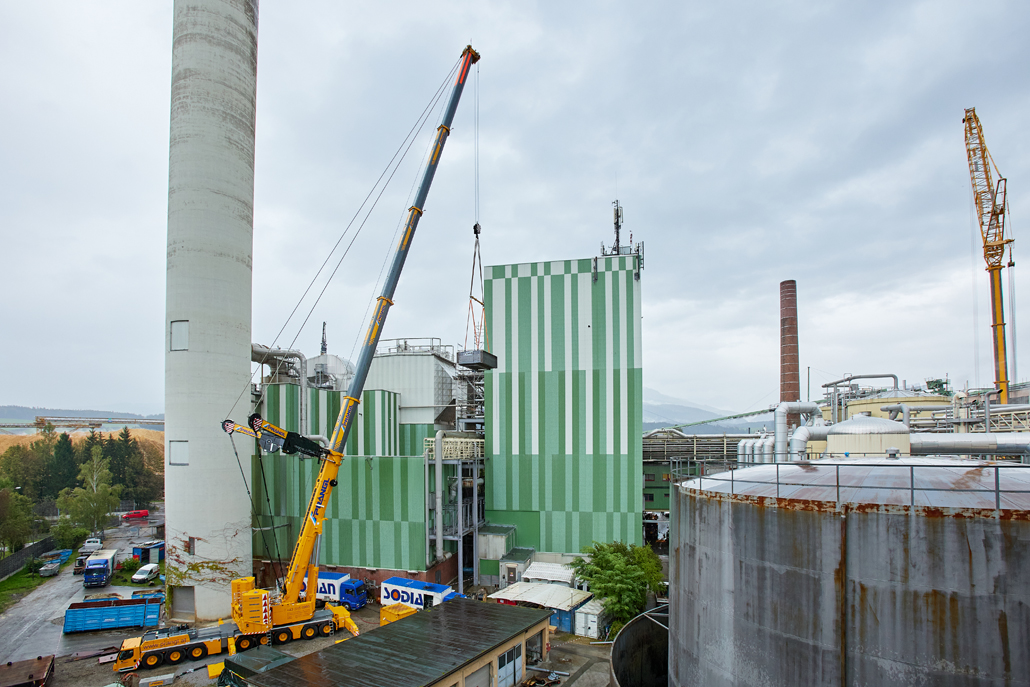

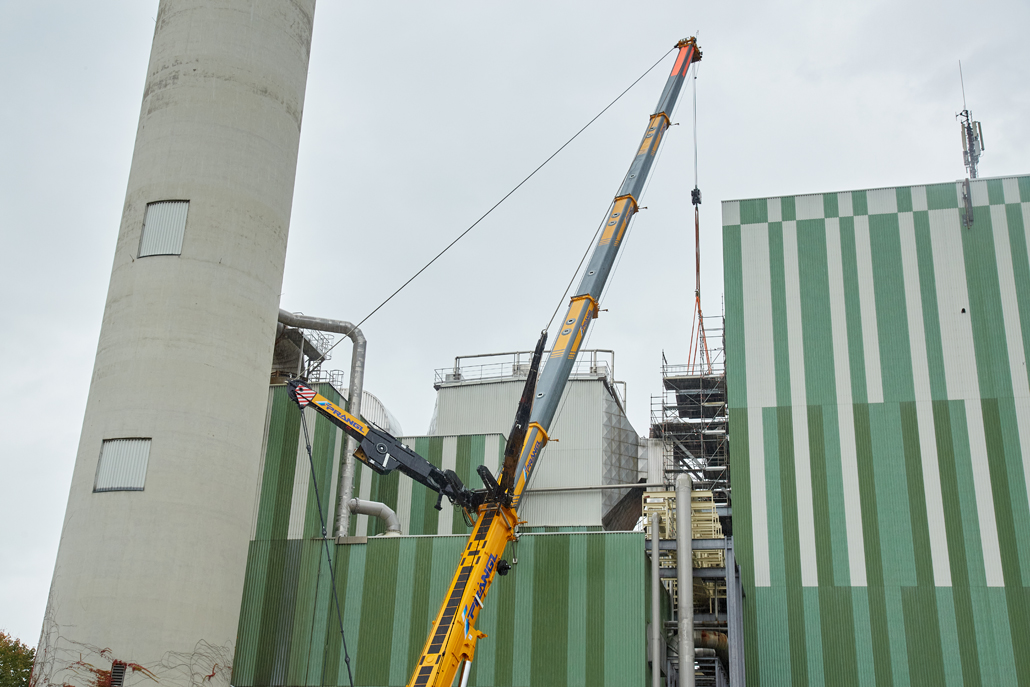

In the first step, the hall wall was opened at the height of the heat exchanger with the help of a 160 tonne telescopic crane, followed by assembly of an auxiliary structure. Then, a specially designed rail system was installed which made it possible to slide in and out as well as lift the heat exchanger packs. The precisely positioned 700 tonne mobile crane first lifted out the smaller components of the old heat exchanger. The main pack of the old heat exchanger was pushed out and safely removed by the heavy-duty crane. Then, the new heat exchanger was placed on the auxiliary structure with millimetre precision, inserted and installed.

A complete success

Thanks to detailed preliminary planning and precise preparation, the operation went exactly according to plan - no surprises or delays. An additional order that was won thanks to the convincing concept, comprised of the disassembly and replacement of a pipe bridge using a 500 tonne telescopic crane and was implemented just as smoothly. The operation in Hallein was a complete success for the Prangl team. The first performance of the new 700 tonne mobile crane also went perfectly. The satisfaction of the client once again highlights successful collaboration.

Industry

The highest precision and reliability are our aspiration - for every project.
Silvio AuingerSales / Consulting

Cookies

This website uses technically essential cookies. We also require your consent to functional cookies in order to display videos. If you consent to statistical cookies, we will anonymise and collect the user behaviour and therefore optimise user friendliness. For more information, click our data privacy statement.
